JCT D&B 2011 – Helpful Timeline Diagrams – Back to Basics #37
Final Statement Timelines Under JCT
As we still see numerous clients using the 2011 versions of the JCT Contracts, our previous Back to Basics timeline looked at Interim Payment Timelines applicable under the JCT Design & Build 2011 Contract. Today’s diagram looks at the issuing of the Final Statement and the dates applicable to the Final Payment. Our next reviews will look at the Interim Payment Timelines and the Final Statement Timelines of the 2016 version of the JCT Design & Build Contract.

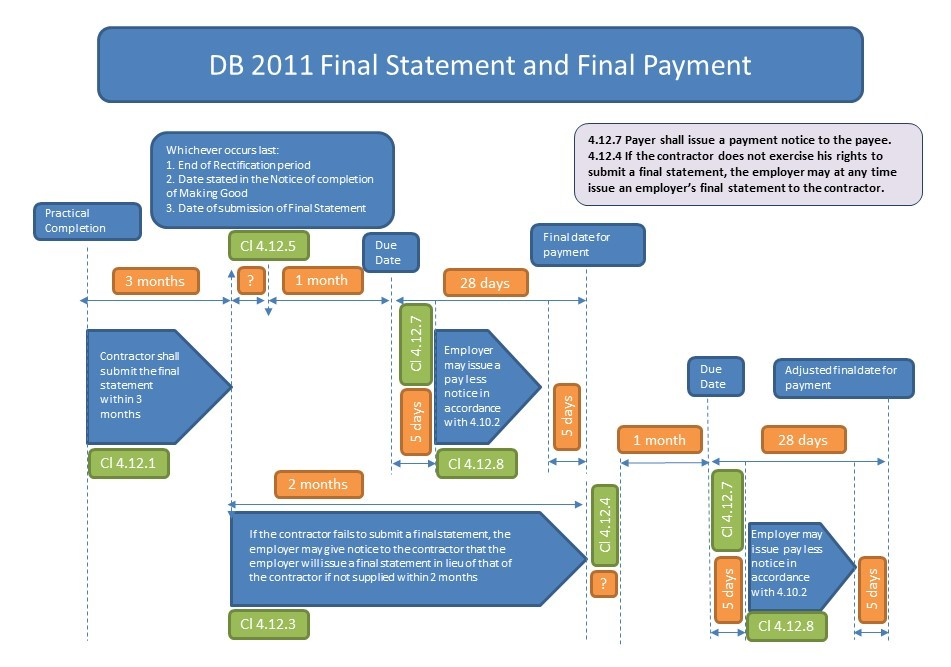

The diagram below shows how the date of the Final Payment can be affected by the Contractor submitting its Final Statement under the JCT Design & Build 2011 Contract:
It’s important that each party is aware of the steps and timescales that apply, should a disagreement arise in relation to the Relevant Statement.

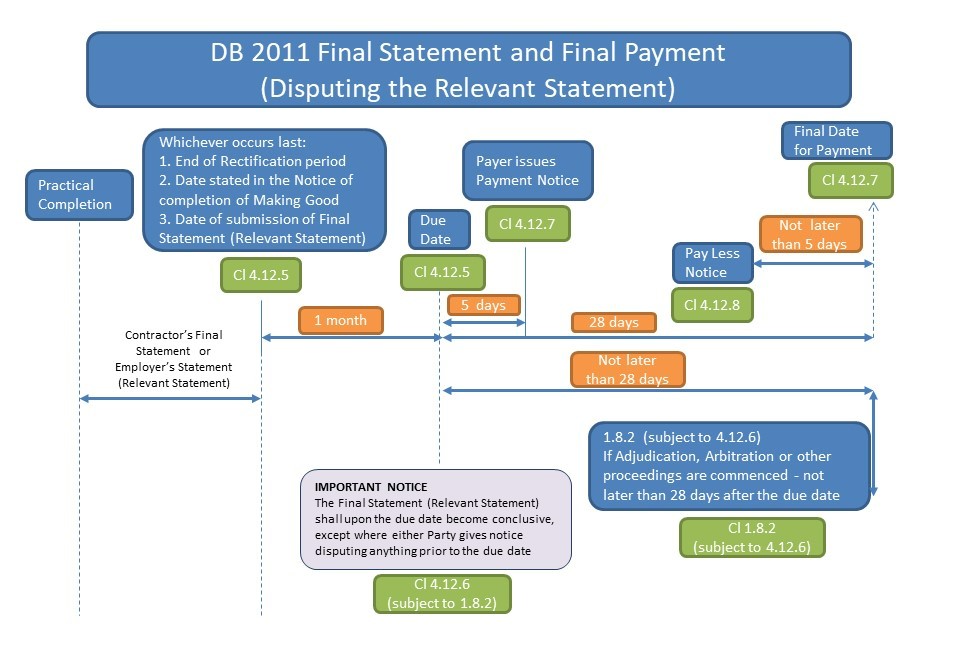

The diagram below shows the timescale applicable should a Relevant Statement be disputed:
If you need assistance settling a Final Account under a JCT form of Contract or any matter associated with this suite of Contracts, Ramskill Martin’s Team of Consultants can assist you, whether the issue is related to Contract, Commercial or Programming / Time.
-
Sheffield
The Annexe,
260 Ecclesall Road South,
Ecclesall,
Sheffield,
S11 9PSTel - 0114 230 1329
-
London
Adam House,
7-10 Adam Street,
London,
WC2N 6AATel – 020 7520 9295
-
Leeds
Suite 69,
4100 Park Approach,
Thorpe Park,
Leeds,
LS15 8GBTel - 0113 397 0358
-
Warrington
Suite 41,
Lakeview 600,
Lakeside Drive,
Centre Park Square,
Warrington,
WA1 1RWTel - 01925 984705
