JCT D&B 2011 – Helpful Timeline Diagrams – Back to Basics #36
Interim Payment Timelines Under JCT
Continuing our Back to Basics Series on payment timelines under different forms of contract, today’s diagrams are for the Interim Payment under the JCT Design & Build (DB) Contract. We still see many clients using the 2011 version of the JCT Contracts, so in this review we look into the Interim Payment Timeline of the 2011 version and we will review the 2016 version separately in the series.
The diagram below represents a simplified version of the Interim Payment Timeline under the JCT Design & Build 2011 Contract:

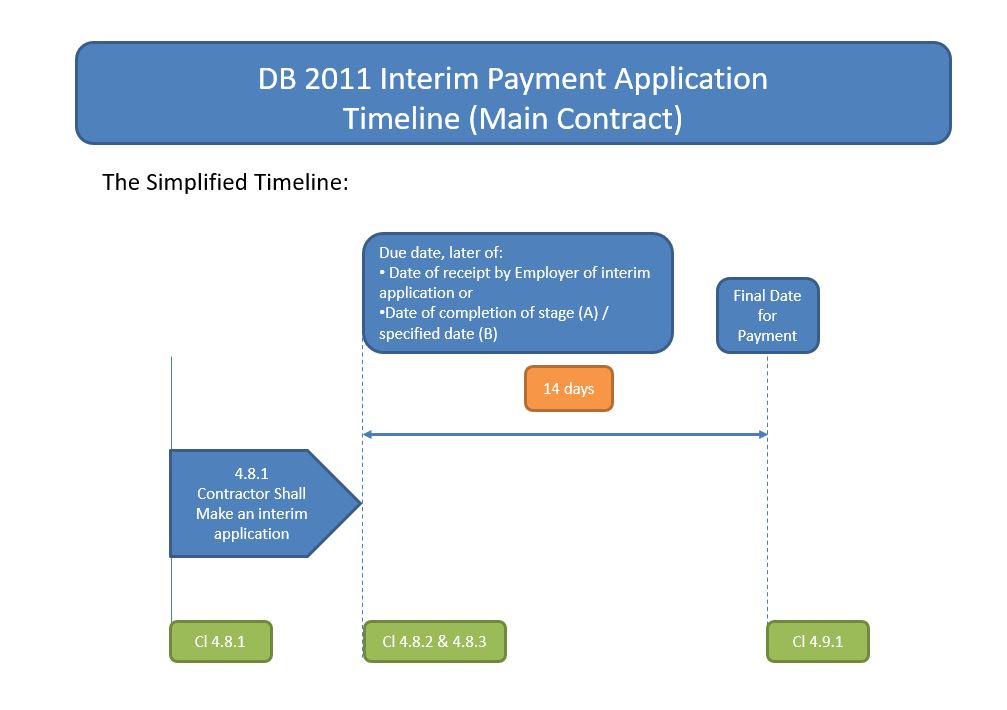

The JCT Design and Build Contract specifies a period of 14 days from the Due Date to the Final Date for Payment. Alongside specifying the general period applicable to Interim Payment, the Contract also specifies the timescales applicable for the issuing of Payment Notices and Pay Less Notices. It is important that parties are aware of these periods, as failure to issue the relevant notice in time could result in the Employer being obliged to pay the sum stated in the Contractor’s interim application.

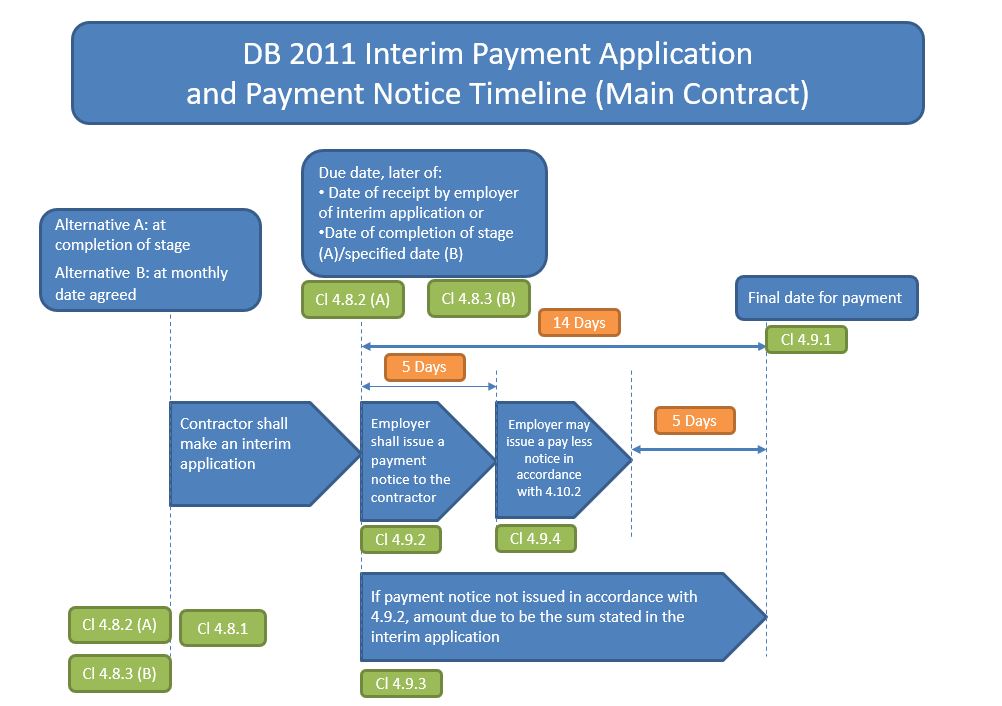

The diagram below shows more detail of the steps and periods applicable to Interim Payments under the JCT Design and Build 2011 Contract and identifies the dates that the relevant notices need to be issued:
If you need assistance with anything involving payment under a JCT form of contract or any matter associated with this suite of contracts, Ramskill Martin’s Team of Consultants can assist you, whether the issue is related to the Contract, Commercial matters or Programming / Time.
-
Sheffield
The Annexe,
260 Ecclesall Road South,
Ecclesall,
Sheffield,
S11 9PSTel - 0114 230 1329
-
London
Adam House,
7-10 Adam Street,
London,
WC2N 6AATel – 020 7520 9295
-
Leeds
Suite 69,
4100 Park Approach,
Thorpe Park,
Leeds,
LS15 8GBTel - 0113 397 0358
-
Warrington
Suite 41,
Lakeview 600,
Lakeside Drive,
Centre Park Square,
Warrington,
WA1 1RWTel - 01925 984705
