Back to Basics #35 - NEC 3 – Helpful Timeline Diagrams
CE Quotation Timelines under NEC
As mentioned last time, as part of our Back to Basics series, we have provided you with some useful diagrams that we have prepared to help you understand various contract timelines.
These can be printed off (if you are old school) or saved to your computer to act as a useful aide memoire which we hope you find useful.
Today’s diagram is for the Compensation Event Quotation Timeline under NEC3.

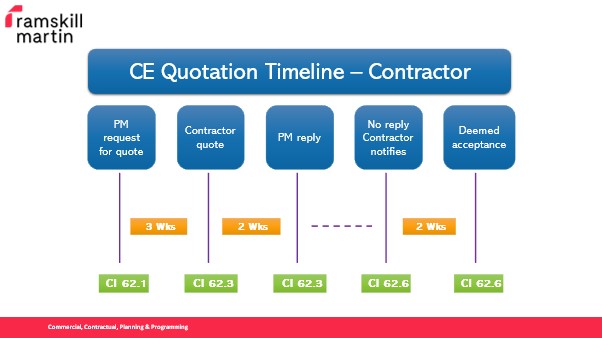

Below is the Timeline for the NEC3 Engineering and Construction Contract MAIN CONTRACT:
The Sub-Contract is a similar process BUT the durations are amended to ensure that the Main Contract can fulfil its obligations.

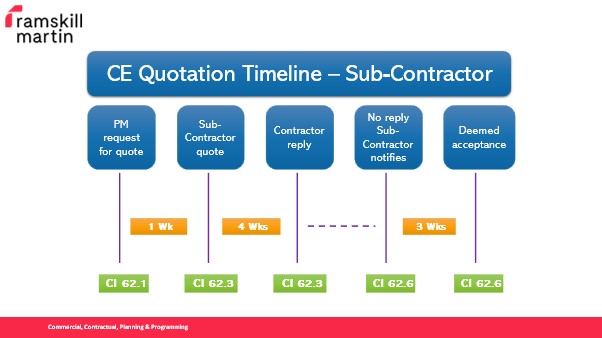

Below is the SUB-CONTRACT Timeline:
-
Sheffield
The Annexe,
260 Ecclesall Road South,
Ecclesall,
Sheffield,
S11 9PSTel - 0114 230 1329
-
London
Adam House,
7-10 Adam Street,
London,
WC2N 6AATel – 020 7520 9295
-
Leeds
Suite 69,
4100 Park Approach,
Thorpe Park,
Leeds,
LS15 8GBTel - 0113 397 0358
-
Warrington
Suite 41,
Lakeview 600,
Lakeside Drive,
Centre Park Square,
Warrington,
WA1 1RWTel - 01925 984705
-
Manchester
3 Hardman Street,
Manchester,
M3 3HFTel - 0114 230 1329
-
Birmingham
Birmingham Business Park,
4200 Waterside Centre,
Solihull Parkway,
Birmingham,
B37 7YNTel - 0121 481 2381
-
Liverpool
Horton House,
Exchange Flags,
Liverpool,
L2 3PFTel - 07753 837149
