NEC 3 – Helpful Timeline Diagrams – Back to Basics #34
Over the next few weeks, as part of our Back to Basics series, we thought that we would provide you with some useful diagrams. We have prepared these to help you understand various contract timelines.
These can be printed off (if you are old school) or saved to your computer to act as a useful aide memoire.
Today’s diagrams are for the Compensation Event Notification Timeline under NEC3.

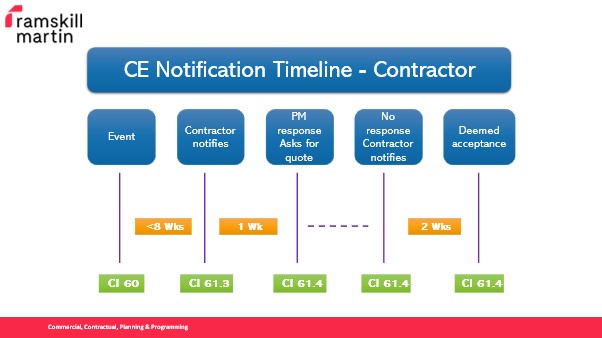

Below is the Timeline for the MAIN CONTRACT:
The Sub-Contract is a similar process BUT the durations are slightly reduced to ensure that the Main Contract can fulfil its obligations.

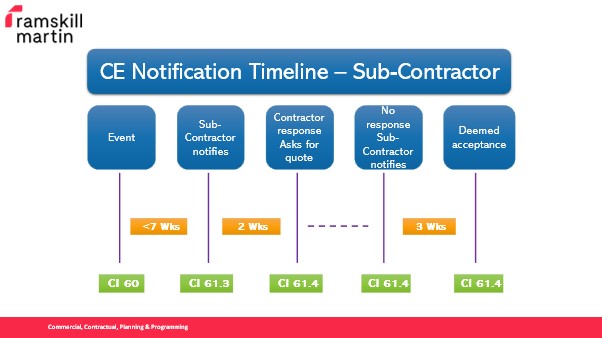

Below is the Sub-Contract Timeline:
If you need assistance with anything involving Compensation Events under NEC 3 or 4 or any matter associated with these contracts, Ramskill Martin’s Team of Consultants can assist you, whether the time is related to Contract, Commercial or Programming / Time.
-
Sheffield
The Annexe,
260 Ecclesall Road South,
Ecclesall,
Sheffield,
S11 9PSTel - 0114 230 1329
-
London
Adam House,
7-10 Adam Street,
London,
WC2N 6AATel – 020 7520 9295
-
Leeds
Suite 69,
4100 Park Approach,
Thorpe Park,
Leeds,
LS15 8GBTel - 0113 397 0358
-
Warrington
Suite 41,
Lakeview 600,
Lakeside Drive,
Centre Park Square,
Warrington,
WA1 1RWTel - 01925 984705
-
Manchester
3 Hardman Street,
Manchester,
M3 3HFTel - 0114 230 1329
-
Birmingham
Birmingham Business Park,
4200 Waterside Centre,
Solihull Parkway,
Birmingham,
B37 7YNTel - 0121 481 2381
-
Liverpool
Horton House,
Exchange Flags,
Liverpool,
L2 3PFTel - 07753 837149
